A freshly constructed four-story parking structure has one major thing in common with a blank sheet of paper: everything that happens next is permanent. When Harkins Builders contracted Proline to complete the striping and wheel stop installation for Junction 49’s new mixed-use parking deck in Charlotte, we were working with new concrete across four levels, zero existing markings, and a project timeline that required all four levels to be completed in five consecutive workdays before the building’s opening schedule.
We designed the layout from blueprints, executed it level by level, installed 191 concrete wheel stops, designated ADA-compliant and EV charging stalls, managed a rooftop level in full sun and wind exposure, and passed the final walkthrough on schedule. Here is the full picture of how multi-level parking deck striping actually works — and what distinguishes this kind of project from a standard surface lot job.
Why Parking Decks Are Not Surface Lots
Property owners who have managed surface lot maintenance sometimes assume that a parking deck is simply more of the same: more square footage, more stalls, more paint. The reality is that a multi-level parking structure introduces a set of variables that require different preparation, different technique, and a different level of pre-job coordination than any flat lot project.
The Substrate Is Different
Surface lots are asphalt. Parking structures are poured or post-tensioned concrete. Traffic-grade paint adheres to these surfaces differently. Concrete requires specific surface preparation — the deck must be free of curing compounds, laitance, dust, and moisture before paint is applied, or adhesion fails. On a newly constructed deck, construction dust and residual form-release agents are often present and must be removed systematically before any marking work begins.
The paint formulation also matters. We use traffic-grade paint specified for concrete application — not the same product used on asphalt. Applying asphalt-grade traffic paint to a concrete deck produces premature peeling and a callback that no one wants.
The Layout Cannot Be Improvised
On a surface lot restripe, the existing layout provides a guide. On new construction with no prior markings, the layout is designed from architectural drawings. Stall width, drive aisle dimensions, turning radii, ADA stall count and position, EV charging zone placement, loading area clearances — these all come from the permit drawings. Any deviation from the permitted layout creates a compliance problem that may require re-work before a certificate of occupancy is issued.
We do not estimate stall positions on-site. We build the layout in advance from the architect’s drawings, verify dimensions against the physical deck before marking begins, and snap chalk reference lines before the paint machine rolls.
Vertical Staging Changes Everything
On a surface lot, all equipment is on the same level. On a four-story deck, the striping machine, the adhesive applicator for wheel stops, pallets of concrete wheel stops, and the rebar drilling equipment all have to be staged on each level via freight elevator in coordination with the GC’s active construction schedule. At Junction 49, we coordinated level-by-level equipment moves with Harkins Builders’ site superintendent, working around the other trades finishing interior work simultaneously.

The Junction 49 Project: Scope and Context
Junction 49 is a newly developed mixed-use property in the Charlotte metro. The parking structure serves the residential and commercial tenants of the development, with specific requirements for EV charging access and ADA compliance built into the building permit.
Project scope at a glance:
- Four levels of parking including a rooftop level
- New concrete deck on all levels — no prior markings
- ADA-compliant accessible stalls per ADAAG requirements
- EV charging station designations aligned with the building’s electrical plan
- Hash boxes and stenciling for no-park zones, drive aisles, and pedestrian paths
- 191 concrete wheel stops installed across all four levels
- Completion timeline: five consecutive workdays
Phase 1: Layout Design From Blueprints (Pre-Mobilization)
The first day of this project happened off-site. Before a single truck moved toward Junction 49, we worked through the architectural drawings to produce a complete marking layout for all four levels.
Stall count optimization. Architects design for maximum stall count. Parking operators need maximum usability. Stalls that are technically code-compliant in width may be functionally tight for the vehicle mix using the facility. We reviewed the stall dimensions against the building’s target tenant profile and flagged two areas on Level 2 where drive aisle geometry created difficult turning movements — noted for discussion with Harkins before painting.
ADA positioning. ADA stalls must be the closest accessible spaces to the accessible building entrance on each level. The position requirement is not just a count requirement — location matters for compliance. We mapped the accessible route from each level’s designated ADA stalls to the elevator and stairway access points and confirmed routes were clear before work began.
EV charging alignment. EV stall markings need to be centered on the electrical conduit stub-up locations. We received the electrical rough-in drawings from the GC and overlaid them against our stall layout before finalizing positions.
Wheel stop placement. 191 wheel stops across four levels means 191 positions pre-planned, not improvised on-site. Each stop needs to be set at the correct distance from the stall line — typically 24 to 30 inches from the stall end — to stop a vehicle’s tire at a point that leaves the bumper clear of the wall, column, or adjacent stall.

Phase 2: Level 1 — Surface Prep, Marking, and Wheel Stops
Level 1 is the entry level and the highest-visibility floor. Every car that parks on levels 2 through 4 passes through Level 1 entering and exiting. The quality of Level 1 sets the standard for the project and the perception of the property.

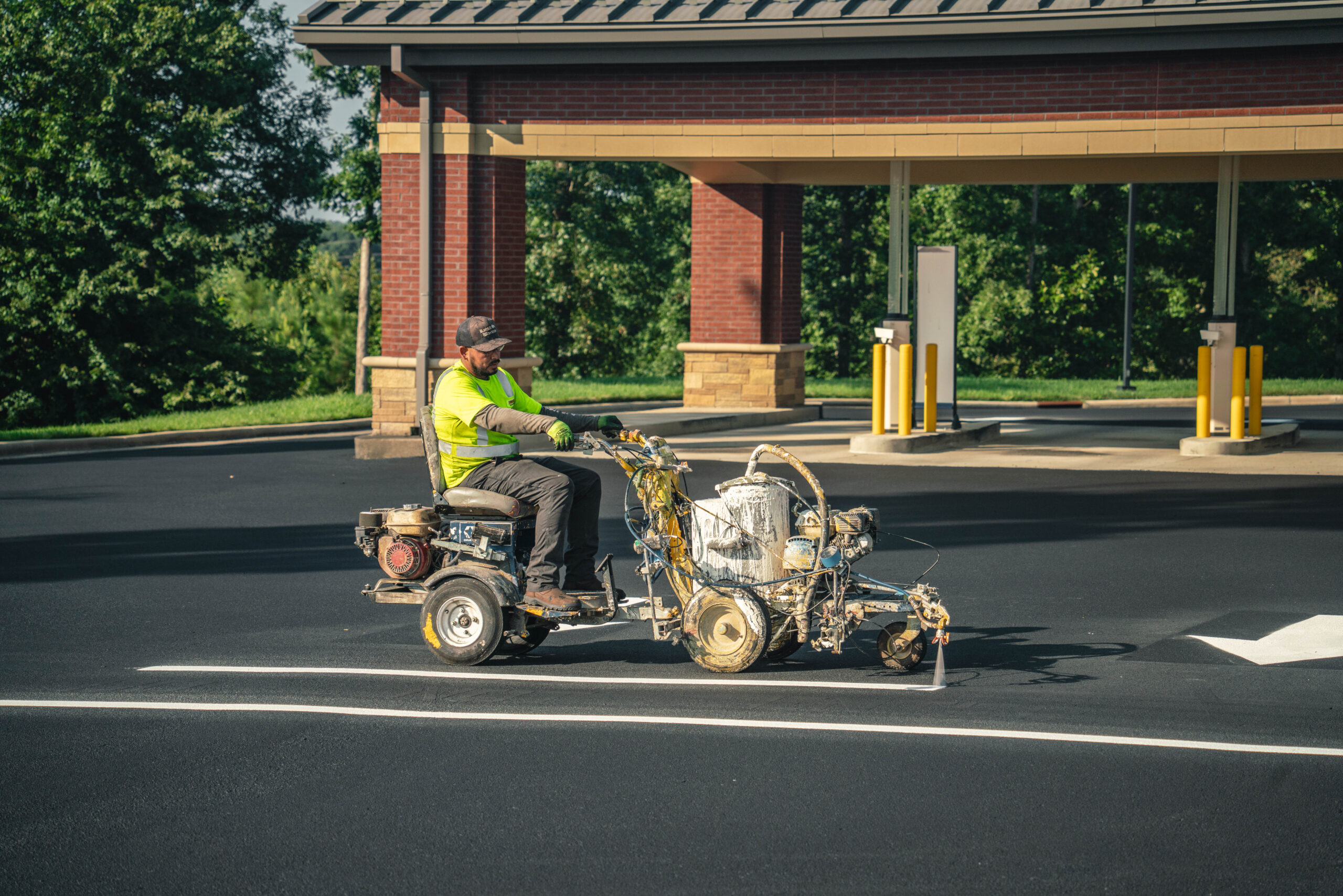

Our Level 1 sequence: sweep and blow the full deck surface, remove any curing compound or dust; snap chalk reference lines from the layout drawing; apply stall lines and drive aisle lines in two passes per line; paint stop bars and directional arrows; stencil ADA symbols, EV charging designations, no-park hash boxes, and stall identifiers; install concrete wheel stops — positioned per plan, set in structural adhesive, pinned with rebar driven into the concrete deck.
Rebar pinning is not optional for deck installations. Wheel stops that are adhesive-only migrate under repeated vehicle contact and become trip hazards within months. We pin every one.
Phase 3: Levels 2 and 3 — Systematic Execution
Levels 2 and 3 followed the same sequence as Level 1. With the design locked and the crew in rhythm, these levels moved faster. The key coordination variable was equipment staging — every move between levels required freight elevator time coordinated with the GC’s site schedule.
One detail specific to interior deck levels: lighting. Covered parking structures have significantly less natural light than surface lots, and illumination varies across a level depending on fixture layout. We adjusted paint application pass speed in lower-light areas to ensure consistent film thickness — a thin application in a dim area shows up as differential wear after six months of use.

Phase 4: The Rooftop Level — Adjusted Technique
The rooftop level is technically the most straightforward — no walls, no columns, maximum access. It is operationally the most demanding because of environmental conditions that do not exist on the lower levels.
Sun glare. A white concrete deck in direct Charlotte summer sun creates significant glare that makes it difficult to evaluate line position and straightness in real time. We use physical guides — chalk lines and straight-edge rails — more extensively on the rooftop than on interior levels, because visual judgment alone is not reliable in those conditions.
Wind. Paint applied to an outdoor deck in wind conditions can drag before it sets, creating feathered edges rather than sharp lines. Our crew adjusted application speed and technique based on wind conditions, working with a wind reading at the start of each work session. On Day 5 morning, we had a 12-mph wind from the southwest — workable, but requiring slower machine speed and immediate edge inspection behind the applicator.
Temperature and cure time. A rooftop deck in direct sun heats to surface temperatures significantly above air temperature — we recorded deck surface temperatures above 110°F during afternoon hours. At high surface temperatures, traffic-grade paint flashes dry extremely fast. Our crew started rooftop work at 6:30 AM, completed all field work before noon, and saved stenciling for the afternoon session when working time before the paint grabbed was maximized.
Phase 5: Quality Walk and Final Sign-Off
Our crew lead walked every level before calling the Harkins Builders project manager for the sign-off walk. The checklist: ADA stall count and position match permit drawings on each level; van-accessible designation present and correctly signed; EV stall markings centered on electrical stub-up locations; all 191 wheel stops secure via pull test; no paint holidays in stall lines or stop bars; arrow direction matches traffic flow design; no stenciling errors in ADA symbols, numbering, or EV designations; rooftop edge line quality matches interior levels.
One stop bar on Level 3 required a second pass — the first coat had been applied over a dust area not fully cleared. We corrected it on the spot. Everything else passed. Job signed off on Day 5 as scheduled.
The 191 Wheel Stops: Why This Number Matters
Property owners sometimes treat wheel stops as optional. We treat them as required infrastructure. What wheel stops prevent in a parking structure:
Vehicle overrun at deck edges. A vehicle that rolls past the stall boundary on an upper level does not hit a curb — it hits a concrete parapet or, in a worst case, has nothing between it and the structural edge. Wheel stops stop the tire before the bumper reaches the wall.
Column and wall damage. Parking structures accumulate column and wall damage from bumper contact at a rate that accelerates maintenance costs and eventually compromises the finishes required for a Class A commercial property. Wheel stops eliminate this contact.
Trip hazard liability if improperly installed. A wheel stop that migrates — because it was adhesive-only without rebar pinning — creates a trip hazard at exactly the height range that causes falls. Rebar-pinned wheel stops do not migrate. We pin every one.
What Developers and Property Managers Should Look for in a Deck Striping Contractor
Blueprint review before pricing. Any contractor quoting a multi-story deck who has not reviewed the permit drawings is guessing on stall count, ADA requirements, and wheel stop quantities. A quote based on guesses produces change orders on-site.
Concrete-specific products. Ask specifically what traffic paint formulation is being used and whether it is rated for concrete application. The wrong product will fail within one to two years on a concrete deck.
Wheel stop installation method. Ask whether wheel stops are adhesive-only or rebar-pinned. If the answer is adhesive-only, that is the wrong answer for a parking structure.
ADA and EV coordination. These designations need to match the permit drawings and the building’s electrical plan. A contractor who does not ask for these drawings before finalizing a layout cannot guarantee compliance.
Frequently Asked Questions
How long does parking deck striping last?
Traffic-grade paint on concrete in a covered parking structure typically lasts four to seven years before requiring a full restripe, depending on traffic volume. Rooftop levels exposed to UV and weather may need refreshing at three to five years. Individual high-wear zones near exits and elevator lobbies often need touch-ups before the full restripe cycle.
Can parking deck striping be done while the deck is in use?
Yes, with a phased approach. We section the deck by level or zone, stripe and allow to cure, then open that section and move to the next. For an occupied building, we typically schedule level-by-level closures of 24 to 48 hours. We coordinate the schedule with property management to minimize disruption to tenants.
Do you handle both new construction and restripes on parking decks?
Yes. New construction is the most complex scope because everything is designed from scratch. Restripes follow the existing layout with corrections for wear, compliance updates, or layout changes requested by the property manager. We have done both extensively in the Charlotte market.
Parking Deck Striping and Wheel Stop Installation Across the Carolinas
Proline works with developers, general contractors, and property management firms on parking structure projects throughout Charlotte, Huntersville, Winston-Salem, Greensboro, and the surrounding Carolinas. If you have a new construction or restripe project in planning, contact us to discuss scope and schedule.
704-530-5366 | info@prolineplm.com
